Builds Overview

A build is the core action in Partsemble — it's the act of manufacturing a product. When you execute a build, Partsemble consumes component inventory according to the bill of materials, produces the finished good, calculates costs, and records everything for your books.

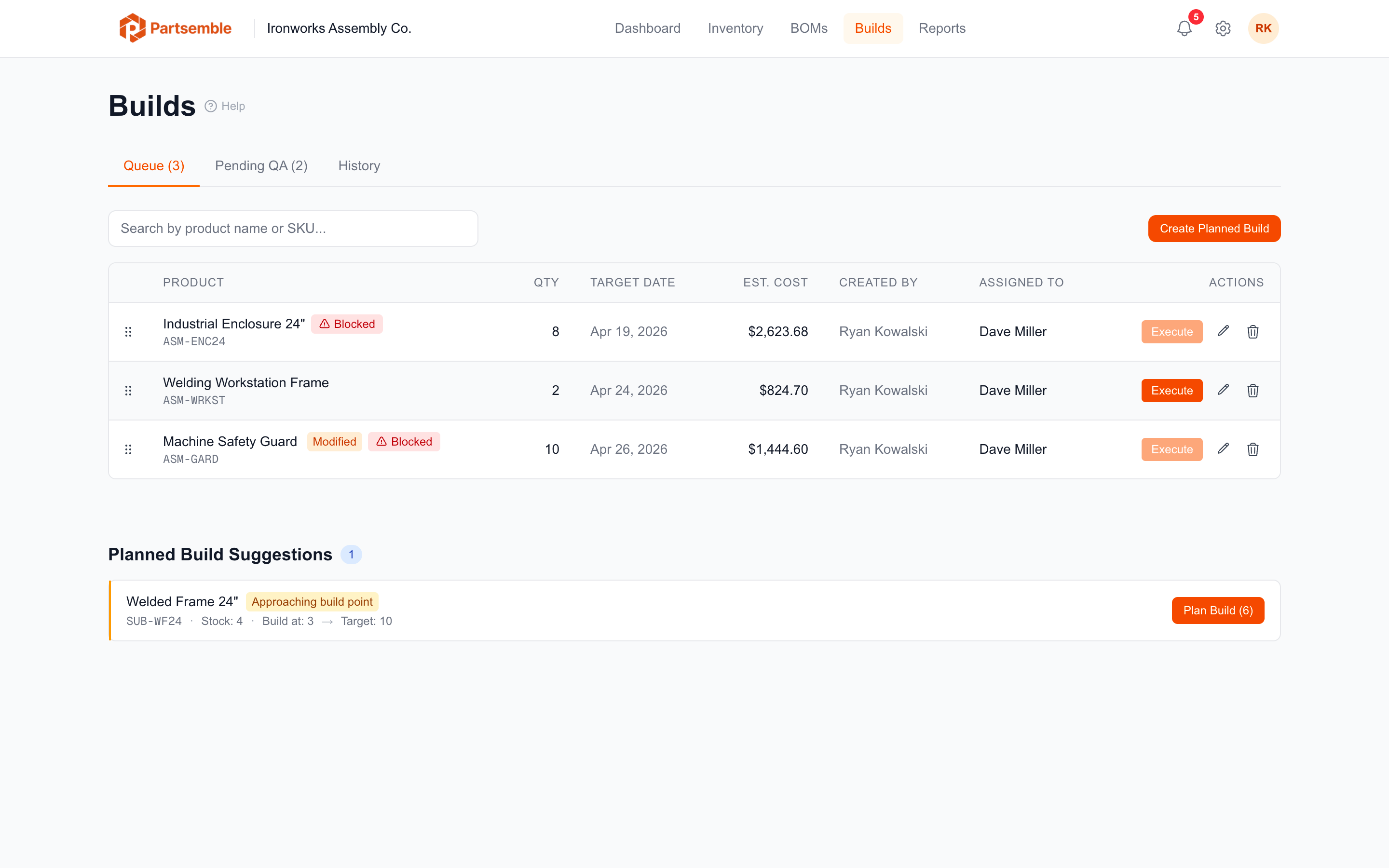

Build queue listing five planned builds in order, with their quantities, target dates, estimated costs and Execute buttons, and Planned Build Suggestions below

The Build Lifecycle​

Every build follows a lifecycle. The steps depend on your settings:

Standard flow (no QA): Planned → Pending Export → Exported

With QA review enabled: Planned → Pending QA → Pending Export → Exported

Approving a build is what moves it from Pending QA to Pending Export. The approval is recorded in the build's history, with who approved it and when; it is not a status of its own.

Quick builds skip the planning step — they go directly from execution to pending export (or to QA if enabled).

Each status transition is tracked with a timestamp and the user who performed it, giving you a complete audit trail.

Two Ways to Build​

Quick build — select a product, set a quantity, and execute immediately. Best for routine production when you don't need to plan ahead. See Quick Builds.

Planned build — create a build with a target date, optionally assign it to a team member, and add it to the build queue. Execute it when you're ready. Best for scheduling and team coordination. See Planning Builds.

Both methods use the same underlying execution engine. The difference is in the workflow leading up to the build.

What Happens During a Build​

When a build executes, Partsemble does the following in a single atomic transaction:

  1. Validates — checks that the BOM is active, components have sufficient stock, and any assignment requirements are met
  2. Consumes components — decreases stock on hand for each component by the quantity defined in the BOM, multiplied by the number of units built
  3. Records cost — captures the weighted average cost of each consumed component at the time of execution, plus any cost lines from the BOM
  4. Produces the finished good — increases stock on hand for the output product (unless QA review is required, in which case production is deferred until approval)
  5. Creates stock transactions — an immutable ledger entry for every inventory movement
  6. Exports to accounting — if auto-export is configured, sends the transaction to your accounting system

If anything fails during execution, nothing is committed — your inventory stays unchanged.

Build Statuses​

StatusMeaning
PlannedScheduled but not yet executed. Sitting in the build queue.
Pending QABuild completed, waiting for quality assurance review. Only appears when QA review is enabled. Approving it adds the finished goods to inventory and moves it to Pending Export.
RejectedFailed QA review. Components may be recovered, partially recovered, or written off as waste. A rejection that leaves something to export, such as lost materials, moves the build to Pending Export instead.
Pending ExportReady to be exported to your accounting system.
ExportedSuccessfully exported to accounting.
Export FailedExport to accounting failed. Can be retried.
